How long does it take to replace a roof? Most asphalt shingle roofs in Maryland are installed in 1 to 3 days. The full project, including inspection, insurance approval, and permits, runs 2 to 6 weeks from your first call to the final cleanup.
A roof replacement is one of the biggest home projects a Maryland homeowner will face. The good news is that it takes far less time than most people expect. This guide breaks down the real 2026 timeline, from your first inspection to the final dumpster pickup.
The Roof Replacement Timeline at a Glance
Most homeowners only think about the noisy installation days. The full project actually has five phases.
- Inspection and estimate (Day 0 to Day 3)
- Insurance and financing approval (Days 3 to 21)
- Permitting and material order (Days 7 to 14)
- Installation (1 to 3 days for most homes)
- Final cleanup, inspection, and warranty registration (Days 18 to 21)
Storm damage and special-order materials can stretch the schedule. A simple repair, by contrast, often finishes in a single morning.
How Long to Replace a Roof by Material Type
The biggest single factor in the install schedule is the material you choose. Here is the typical install window for a standard Maryland home.
- Asphalt three-tab shingles: 1 to 2 days.
- Architectural (dimensional) shingles: 1 to 3 days.
- Standing seam metal: 3 to 6 days.
- Synthetic slate: 4 to 6 days.
- Cedar shake: 3 to 5 days.
- Concrete or clay tile: 8 to 10 days.
- Flat roof (TPO, EPDM, modified bitumen): 2 to 4 days.

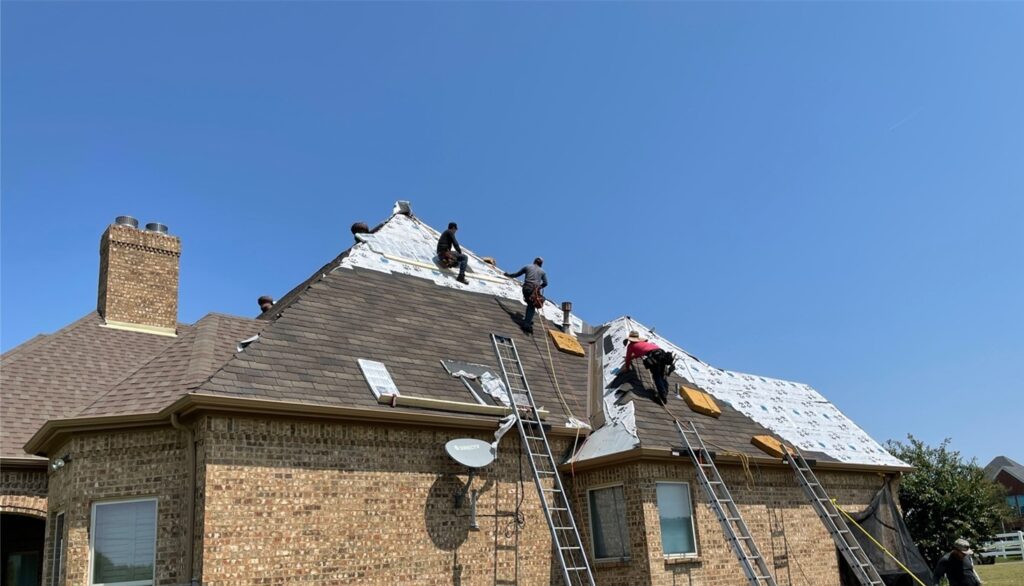

Day-by-Day Installation Schedule
Here is exactly what happens during the install phase on a typical asphalt shingle replacement in Beltsville and the wider DMV.
Day 1: Tear-Off and Decking Inspection
- Crew arrives around 7:00 a.m. and stages a dump trailer in the driveway.
- Old shingles, underlayment, and flashing are stripped down to the wood deck.
- Decking is checked for rot, mold, soft spots, and improper nailing.
- Drip edge and ice-and-water shield are installed in valleys and along eaves.
Day 2: Underlayment and Field Shingles
- Synthetic underlayment is rolled out and stapled across the entire deck.
- Starter shingles are installed along the eaves and rakes.
- Field shingles are nailed in courses up the roof to the manufacturer’s spec.
- Around 70 to 90 percent of the roof is typically complete by sundown.
Day 3: Flashing, Ridge Cap, and Cleanup
- Step flashing is installed at chimneys, walls, and dormers.
- New pipe boots and roof vent flashings are set.
- Ridge vent is cut in for attic airflow, then ridge cap shingles are nailed.
- A magnetic nail sweep is run across the lawn, driveway, and gutters.
- Final walkthrough is completed with the project manager.
On a small townhouse or simple gable roof, the process can compress into a single long day. Larger or steeper roofs may push into a fourth day.
How Long Does It Take to Replace a Flat Roof?
A flat roof replacement on a Maryland home or small commercial building usually takes 2 to 4 days. The variation comes from the membrane type and tear-off complexity.
- TPO (thermoplastic polyolefin): 2 to 3 days. Heat-welded seams require dry weather.
- EPDM (rubber): 2 to 3 days. Adhered or mechanically fastened systems install quickly.
- Modified bitumen: 3 to 4 days. Torch-down and peel-and-stick layers are slower but very durable.
Flat roofs over 5,000 square feet can stretch to a full week. Wet ISO insulation under the old membrane must also be replaced before the new membrane goes down.
How Much Hail Damage to Replace a Roof?
After a storm, the most common question we hear in the DMV is how much hail damage to replace a roof actually requires. Most insurance adjusters use the same benchmark.
The standard rule is 8 hits in a 10-foot by 10-foot test square. If a slope shows that density of impact bruising on shingles, it usually qualifies as a total slope replacement.
Less than 8 hits per square may only qualify for a repair or partial replacement. The size of the hail also matters. Stones one inch or larger almost always cause functional damage.
What Is Included in a Roof Replacement?
A thorough Maryland roof replacement should include every line item below. If a quote is missing any of these, ask the contractor why.
- Tear-off and disposal of all old roofing materials
- New synthetic underlayment across the full roof deck
- Ice-and-water shield in valleys, around penetrations, and along eaves
- New drip edge on eaves and rakes
- Step and counter flashing at walls, chimneys, and dormers
- New pipe boots and roof vent flashings
- Starter strip and full field of shingles
- Ridge vent or upgraded attic ventilation
- Ridge cap shingles installed at the peak
- Building permit, dumpster service, and magnetic nail sweep
- Final inspection and manufacturer warranty registration
Does House Insurance Cover Roof Replacement?
Yes, but only when the damage comes from a covered peril. Wind, hail, lightning, and a fallen tree are typically covered by Maryland homeowners’ policies.
Standard wear, tear, and age-related deterioration are excluded from almost every policy. Most carriers in Maryland pay claims at actual cash value (ACV) first.
After the work is finished, the depreciation is released as a second check, called recoverable depreciation. A reputable contractor will help you submit the final paperwork to collect the full payout.
Is Roof Replacement Tax Deductible?
For a primary residence, a standard roof replacement is not deductible in the year you pay for it. The cost is added to your home’s cost basis and reduces capital gains tax when you sell.
There are two important exceptions to know about:
- Energy-efficient upgrades: Some ENERGY STAR-certified metal or reflective “cool” shingles may qualify under the federal Energy Efficient Home Improvement Credit.
- Rental properties: On a rental, a roof replacement is generally a capital improvement depreciated over time on Schedule E.
Always confirm specifics with a CPA before filing, since IRS rules change each year.
Cost and Factors That Change the Timeline
Roof replacement cost in Maryland in 2026 typically runs $9,000 to $22,000 for asphalt shingles on a standard single-family home. Metal and premium materials can run $25,000 to $55,000 or more.
Factors that shift both price and schedule include:
- Total square footage of the roof surface
- Roof pitch (anything over 8/12 slows the crew and adds safety equipment)
- Number of valleys, dormers, skylights, and penetrations
- Layers of old shingles to tear off
- Condition of the wood decking underneath
- Material availability and special-order colors
- Weather windows in spring and fall (the busiest seasons)
- Permit lead time, which varies by Maryland county
Trusted Roofing Experts in Maryland: Bright View Exteriors
Bright View Exteriors is a roofing and exterior contractor based in Beltsville, Maryland. The company serves homeowners across Maryland, Virginia, Washington DC, and Pennsylvania.
Bright View Exteriors specializes in residential roof replacement, roof repair, siding, gutters, and storm damage restoration. The team handles insurance claim documentation directly with carriers on behalf of homeowners.
Verified Business Credentials
- Licensed and insured roofing contractor based in Beltsville, MD
- Service area covers Maryland, Virginia, Washington DC, and Pennsylvania
- Over 45 years of combined roofing and exterior experience on staff
- 4.9-star Google rating across 133+ verified homeowner reviews
- Free, no-obligation roof inspections with same-week scheduling
- Storm damage and insurance claim assistance handled in-house
- Flexible financing available through GreenSky for qualified homeowners
- Workmanship warranties offered on full roof replacements
Conclusion
A roof replacement is not as long or as disruptive as most homeowners expect. With the right crew and clear weather, the install wraps in 1 to 3 days. The full project, including insurance and permits, closes in 2 to 6 weeks.
Storm-driven and insurance-paid replacements may take a little longer. A contractor who handles the carrier directly keeps the schedule moving and reduces homeowner stress.
If you are a homeowner in Beltsville, the wider Maryland area, Northern Virginia, Washington DC, or Pennsylvania, and you are still asking how long it takes to replace a roof on your specific home, schedule a free inspection with Bright View Exteriors. You will receive a written timeline, an itemized quote, and clear answers before any work begins.
Stay updated on our services and special offers. Connect with us on Facebook, Instagram, and Google My Business.
Contact us today to schedule your inspection or get a free quote.
Frequently Asked Questions
How long does it take to replace a roof on an average home?
Most asphalt shingle roofs on average single-family homes in Maryland are replaced in 1 to 3 days of active installation. The full project, from inspection to cleanup, runs 2 to 6 weeks.
Can a roof be replaced in one day?
Yes. Small townhouses, simple gable roofs, and asphalt shingle replacements under 1,500 square feet are often completed in a single day with a full crew and good weather.
How long does it take to replace a flat roof?
A flat roof replacement usually takes 2 to 4 days. TPO and EPDM systems are installed in 2 to 3 days, while modified bitumen takes 3 to 4 days. Larger commercial flat roofs can run a full week.
How much hail damage is needed to replace a roof?
Most insurance adjusters use the 8 hits in a 10-by-10-foot test square rule. If a slope shows that density of bruising, it typically qualifies as a full slope replacement under the policy.
What is included in a roof replacement?
A complete roof replacement includes tear-off, decking inspection, new underlayment, ice-and-water shield, drip edge, flashing, pipe boots, starter and field shingles, ridge vent, permit, cleanup, and warranty registration.
